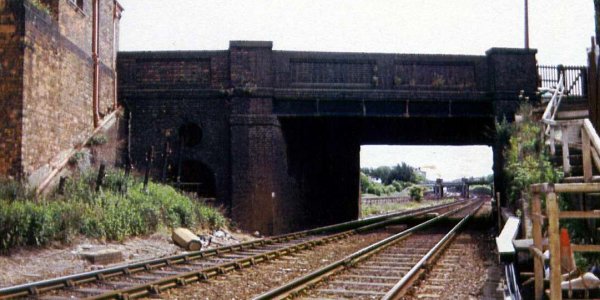

Case Study
Bridge
assessment of a composite deck system
- Re-assessment of
previously failed deck system for 40tonne loading
- Linear static analysis
with model upgrading and element activation/deactivation
- Significant savings in
time and money over previously proposed re-habilitation schemes

Tony
Gee and Partners used
LUSAS Bridge for the analytical study of load and stress
distribution of Neasden Lane Overbridge in London. The bridge
comprises two historically distinct deck systems that are proposed
to be made composite by installing a load sharing mechanism.
Re-assessment of the bridge superstructure to UK code BD 21/01 for
40tonne loading was required as part of the Network Rail Framework
Contract BG3 Programme. As a result of the assessment significant
savings in time and costs were made over previous strengthening
proposals.
Overview
The superstructure of Neasden Lane
overbridge comprises two distinct deck systems, constructed almost
65 years apart, which were intended to act compositely. The
original deck system, constructed circa 1896, comprises 16 steel
Hobsons beams [HBs] placed shoulder-to-shoulder at 760mm centres
between steel edge girders to make the 12.9m wide deck inclusive
of footpaths on both sides. Circa 1960 the original deck system
was strengthened by installing a second deck system comprising of
universal column sections [UCs] installed within the existing
Hobsons beams. Proprietary packing was inserted between the top
flanges of the UCs and the soffits of the HBs in order to make the
two deck systems composite. The strengthening of the HBs was
undertaken on the premise that the old beams were not capable of
carrying loading caused by more modern traffic.
|

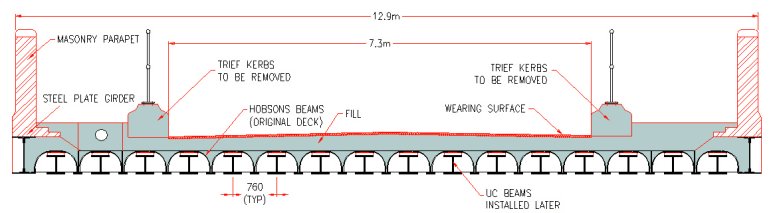

Cross-section
through bridge
|
Previous
inspections
In the late 1990s, following
condition surveys and inspections, the bridge superstructure was
assessed to UK code BD21 and found under strength. The survey and
assessment reports noted that the condition of the HBs was good
with no visible signs of distress. However, it was assumed that
the HBs did not carry any loading and that all load was carried by
the more recent deck system comprising the UCs. Extensive
rehabilitation and strengthening works were envisaged following
the failed assessment. In view of the location of the structure in
a busy urban environment significant costs were foreseen primarily
due to extended railway possessions and road traffic management
during implementation works in addition to major disruption to the
road and rail traffic systems.
Detailed
re-inspection
In 2002, Tony
Gee and Partners were commissioned to carry out detailed
condition surveys of the bridge and to re-assess the
superstructure in order to possibly reduce the scope of
rehabilitation works. A review of past reports and archive
material was conducted and areas of previous studies were
identified that needed further investigation. Bridge inspections
using flexible endoscopic equipment to view previously unseen
areas of the structure were almost startling. It was found that
the packing placed in order to achieve load transfer between the
old and the new deck systems was either missing or had become
dislocated in a substantial part of the deck that was inspected.
As a result, and contrary to what was presumed in earlier reports
and assessments, there was little contact between the old and the
new deck systems and in effect all dead and live loading was being
carried by the old Hobsons beams. The latter installed UCs hardly
appeared to carry any loading other than their self weight.
Feasibility studies
Following the bridge inspections
preliminary calculations investigated the feasibility of using a
more satisfactory load sharing scheme. This primarily envisaged
installing specially seated jacks at predetermined locations
between the old and the new deck systems and inflating them to
pre-calculated loads The objective being to achieve a certain
degree of load transfer from the old system to the new system and
to ensure a composite interaction between the two deck
systems for live loads.
Modelling with
LUSAS
It was agreed with the client,
Birse Rail, right at the onset that given the complex nature of
the scheme it was essential to make use of a powerful finite
element program in order to conduct the analytical study of the
proposed scheme. LUSAS Bridge was used for all phases of
the analysis from the simplified single-element models of various
structural components to the detailed three-dimensional
space-shell models of the superstructure. The steel Hobsons beams
were modelled using 3D shell elements while the UCs were modelled

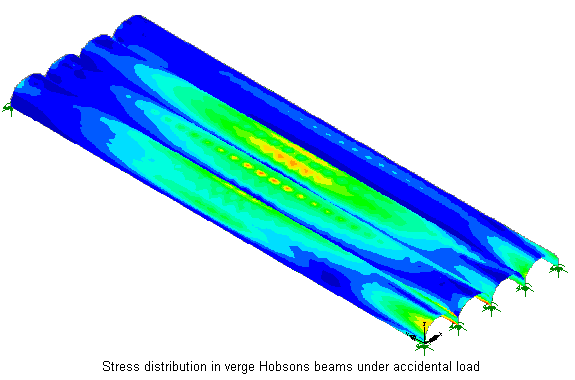

with 3D beam elements. By using the shell elements it was found
feasible not only to model the true geometry of the old deck but
also to study the stress distribution in the HBs under various
loads. This approach also allowed the modelling of the shared
interaction of the common tension flanges of the HBs which would
have been more difficult to idealise in a grillage-type analysis.
All analysis was carried out in the linear elastic domain with
solutions aimed at investigating upper-bound and lower-bound
possibilities of stress distribution under various loads and load
transfer constraints. In this regard particular attention was
given to the modelling of the live load transfer mechanism
provided by the installation of the jacks. The model was gradually
upgraded during the course of the analysis to include the various
features proposed in the rehabilitation works.
Sameer Khan, senior engineer at Tony
Gee & Partners said: "The emphasis of the analytical
study was to explore various possibilities within the constraints
of the project and not necessarily devise one unique solution. In
this regard LUSAS provided an efficient FEA tool in terms of the
wide range of modelling possibilities it allowed. We found it
quick and simple to upgrade an existing model in order to include
new features or de-activate existing ones within a 3D model. In
addition the results processing facilities were particularly
useful in identifying the critical areas of the deck."
Conclusion
Following the analytical studies it
was shown that the two deck systems could be made to achieve a
satisfactory level of load sharing and with minimal rehabilitation
works the superstructure could be strengthened to carry the 40
tonne loading to UK code BD 21/01. The analytical study confirmed
that rehabilitation works envisaged after the earlier failed
assessment could be reduced substantially with associated savings
in time and costs.
|
